Skip to main content

projecten-p01

College des Soeurs des Saints Coeurs - Hadat

This aid project started in May 2023.     IMG 20230707 WA0009

Update november 2025

After two and a half years, the travel advisory was lowered from red to orange, and it was finally safe to travel to Lebanon again. SSCC Hadat was high on my wish list, especially after my previous visit in May 2023.
Together with Bert, Jeannet, Charles and Georges, we were very warmly welcomed on Tuesday 18 November by Sister Labibé and her management team, including all the heads of the various departments. It felt good to be back and able to take the next steps.

Hadat 2025.850 20

There are jobs to be done at SSCC Hadat.
The first person I spoke to was Sister Rita, who was now working in Morocco. Luckily, there was a new IT manager, Eliane Bejjani. We went on another tour of the school with her and Pascalle to get a first impression. It turned out that not much had changed or improved. The internet connection was still poor. Problems with exchanging files, not having a local network server, and poor network infrastructure were seen as major limitations. So there was work to be done!

   Hadat 2025.850 2Hadat 2025.850 3
There are internet connections on the roof.

The work was scheduled for 27 and 28 November. Andre picked me up at 8:00 a.m. and we drove through the busy streets of Beirut to get to SSCC Hadat at 8:30 a.m. We started with a session on a whiteboard. I tried to picture what the IT infrastructure currently looks like and where we want to go.

You can only believe what you can see.
The whiteboard session was stopped a few times so that we could check how the cabling and other things are installed. Once again, there were lots of surprising moments; we didn't expect what was going to happen.

   Hadat 2025.850Hadat 2025.850 12
There are two internet providers. The first uses a point-to-point connection, which means a dish on the roof is aimed at the provider's dish. This delivers the internet signal wirelessly. Drones can cause this connection to be very unreliable, and other drones can also jam them. The signal used for this also disrupts the internet connection, meaning it is regularly unusable.

Hadat 2025.850 9                                                         It takes a long time to work out how connections work.

The other internet connection comes in via fibre optic cable (surprisingly) and is therefore more stable. Please note that we are talking about a 5 megabyte upload/download speed here.

The cabling has been made better.
It took quite a while to work out how the cabling was connected. At first, it was thought that the three buildings were connected to each other wirelessly. But this was later found to be an old connection that was not being used. It now seems that fibre optic cables have been stretched between the buildings, from rooftop to rooftop. Of the two fibres in these cables, only one appears to have been used, which is good news for setting up a local network! The use of old, cheap hardware (max. 100 Mb) means that gigabit speeds cannot be achieved locally (LAN). Once we have replaced this equipment with HP switches that are being managed, we will be able to achieve gigabit speeds in terms of how fast the core network is. This feels good.

There are lots of network cables running from the roof to the floor and then down to the lower floors, and they go through the window frame. Standard network cabling is not good enough for this, and we can see that too: cables are in poor condition, torn or cracked in all kinds of places. We would like to put the cables in the building through cable ducts, but we have decided to replace only the worst cables. There is simply no time to do anything else at the moment, as the school activities must continue, of course.

Hadat 2025.850 11Hadat 2025.850 21

The computer classrooms have been improved.
The computer classroom in building C (Complementary) is set up in a U-shape, with tables against the wall and a few tables in the middle. The cables here are old and in bad condition. The 19 computers are connected to a hub that can handle 100 Mb. Eliane and Fady, the IT teachers, say that they want the tables to be set up like they are in a normal classroom, with three rows of tables facing the whiteboard. We decided to replace all the cabling, install a 19-inch rack and upgrade everything to gigabit speed.

Hadat 2025.850 14Hadat 2025.850 17

Hadat 2025.850 15

The computer classroom in building B (Secondary) has the correct layout, but most of the cabling here is also CAT5, while CAT5e is the minimum standard. We decided to replace most of the old cabling (75%).

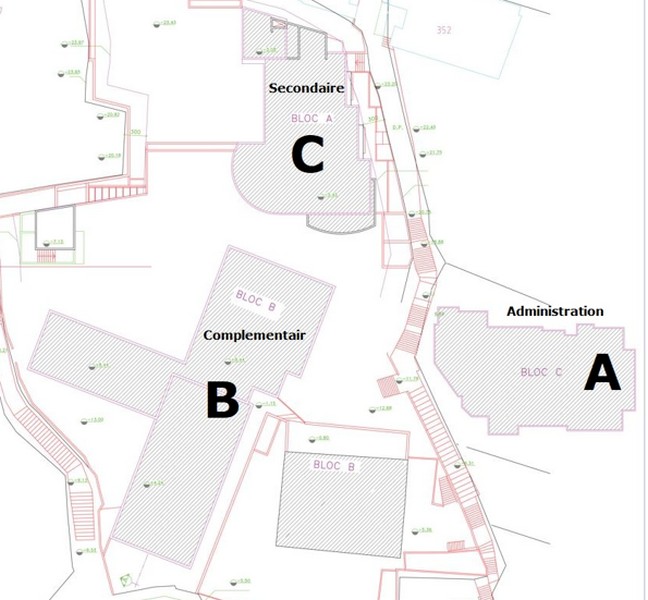

Map of the main network and server room.
We will use the room next to the computer room as the main network location in this building.

Hadat 2025.850 4
                                                    This is how things were before.

We want to install a 19-inch rack here to house switches, patch panels and a new Windows 2022 Server. Unfortunately, the rack is too big to fit through the door. But don't worry, Charbel, who is in charge of looking after the building, quickly decides to take out the whole door frame so that the rack can be brought in.

Hadat 2025.850 5Hadat 2025.850 6Hadat 2025.850 7

Wow, that was done in just 15 minutes!
We could carry on, but it's now 7 p.m. and time to go back to SSCC Bauchrieh to eat and sleep.

SSCC Bauchrieh is here to help.
The next day, I am joined by my good friend Hagop Keork, who works as an IT engineer at SSCC Bauchrieh, to help with replacing the cables. We are picked up at 7:30 a.m. and work on it all day.
I found some worrying things, like a network cable that had been cut and then two 2-wire cables (of the eight) were connected to 230V (!) to power a Wi-Fi transmitter adapter on the other side of the cable.

Hadat 2025.850 8

Extremely dangerous! This does make PoE (Power over Ethernet) better! Anyway, we can't finish the job because more needs to be replaced than we thought. During the day, Fady and Eliane provide us with delicious food, and at 11 p.m. we head back to SSCC Bauchrieh.

This is what it looks like at the end:
On Saturday, we will finish everything. The network is working again and is now very fast and reliable.

Hadat 2025.850 18Hadat 2025.850 16

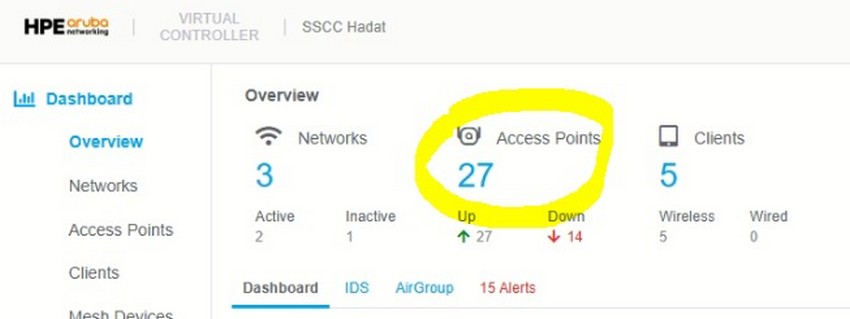

Eliane and I will carry on setting up and getting Windows 2022 Server ready from a distance next week. The first Aruba Wi-Fi access points are now working, and Eliane, Fady and Charbel will continue to set up more Wi-Fi access points in the coming weeks. We are happy to say that we have also been able to provide Wi-Fi in the conference room, which seats around 100 people. This was something that people had been wanting for a long time.
Hadat 2025.850 10                                                   The conference room has Wi-Fi.

Sister Labibé comes to see the finished result and is very pleased with it. We, Eliane, Fady, Charbel, Hagop and I, would like to thank you for your help. I say goodbye feeling very satisfied. Later, I receive a very nice thank-you message. Well done!

Hadat 2025.850 13

The team

Written by Bart Timmermans

December 2023
We received the following photos from Beirut via Mirjam Polak.
